Stage 1 works now complete!
Ocean Reef Marina has reached an exciting new milestone, bringing the vision for this landmark waterfront destination another step closer to reality.
Since construction began in March 2021, the marina has undergone a remarkable transformation. Following completion of the breakwaters in 2023, Stage 1 works commenced in March 2024, delivering new roads and services, boat ramps and jetties, landscaped public spaces and the marina’s first residential precinct.

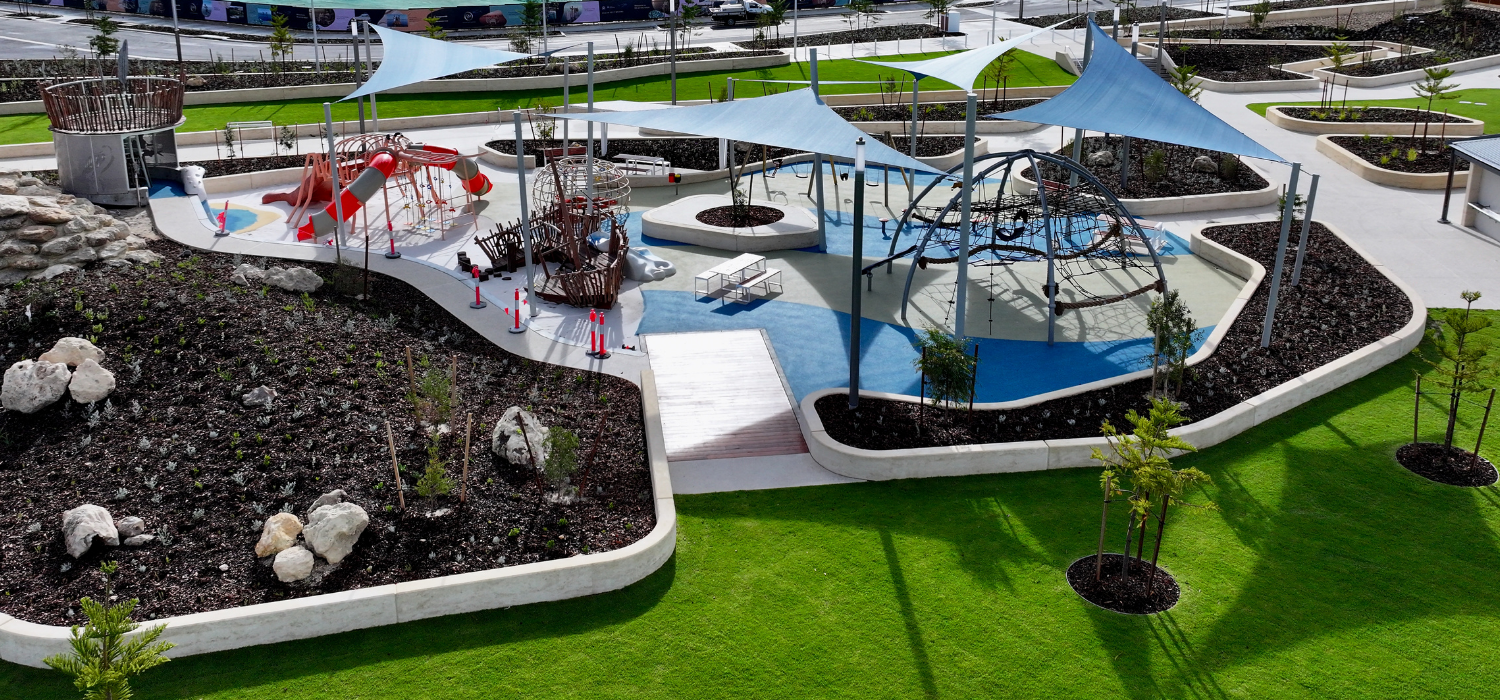

Stage 1 has created 70 residential lots and three development sites, with the first residential land release commencing in September 2026. On 21 November, Marina Cove and the family beach will open to the community, alongside new parklands, an ocean-themed playground and bike pump track.
New facilities have also been delivered for Marine Rescue Whitfords and the Ocean Reef Sea Sports Club, marking another significant milestone for the marina’s boating and community facilities.
And there’s plenty more to come. Ocean Reef Marina will continue to evolve into a vibrant waterfront destination for living, leisure, dining and recreation.
Take a look at the timeline below to see how far the project has come, and what’s still ahead.
Project timeline
Ocean Reef Marina represents one of Western Australia’s most significant development projects. Creating more than 8,600 construction jobs, it will ultimately generate more than $3 billion for the Western Australian economy. The Ocean Reef Sea Sports Club and Marine Rescue Whitfords facilities are now open, and will be followed by the beach and central parkland in 2026, with the marina’s complete build-out scheduled for 2036+.
2036+
Full build-out of marina
Full completion of Ocean Reef Marina marks a new chapter for Perth’s northern coast, with a thriving community of residents and businesses bringing the precinct to life.

2030
Civil construction complete
Final stage of civil construction anticipated to reach completion, setting the stage for final development phases.

2028
Coastal pool
The eight-lane coastal pool is anticipated to open in 2028.

2026
Release of first residential lots and central parkland area to open
The first residential lots hit the market, offering the public their first opportunity to secure a piece of this landmark coastal development. Later in 2026, the marina’s recreational heart is anticipated to open to the public, featuring the signature lobster-themed playground and expansive parklands, as well as the internal protected beach.

Late 2025
Ocean Reef Sea Sports Club/Joondalup City RSL & Marine Rescue Whitfords relocate to new facilities
A milestone year as Ocean Reef Sea Sports Club, Joondalup City RSL, and Marine Rescue Whitfords, and Department of Transport Marina Manager are anticipated to move into their contemporary new facilities.

Mid 2024
Construction of Ocean Reef Sea Sports Club/Joondalup City RSL & Marine Rescue facilities commenced
Byte Construct began work on state-of-the-art facilities for Marine Rescue Whitfords (which will also house the Department of Transport Marina Manager) and Ocean Reef Sea Sports Club building (which will also be home to Joondalup City RSL).

Early 2024
Stage 1 subdivision works commenced by Georgiou Group
Georgiou Group started the $107 million Stage 1 works, laying the groundwork for infrastructure, amenities and the highly anticipated coastal pool.

Early 2024
Internal works complete

August 2023
Breakwater construction completed by WA Limestone and Italia Stone Group
WA Limestone and Italia Stone Group JV complete the breakwaters – the southern wall spanning 1.2km and northern wall reaching 670m, both rising to 8m above sea level.

December 2022
Release of first town centre development opportunity.

August 2022
Internal works commenced
Clearing, earthworks, dredging, land reclamation, construction of internal marine wall.

April 2021
Breakwater construction commenced
Breakwater construction in water works commenced.

March 2021
Early works completed
